Grove City - Zuber Project Improvements

We’re working to upgrade the power grid in your area to continue providing safe, reliable electricity that meets your needs. As part of our continued work, we're upgrading the electric system and equipment to support the area's growing energy needs. These improvements will help meet existing electric needs and support future growth in your community by providing greater capacity and improved reliability.

We’re committed to keeping you informed and minimizing the impact to homes, businesses and the environment throughout the duration of this project. Please visit this page periodically for ongoing project updates.

Thank you for your continued patience as we work to improve your electric service.

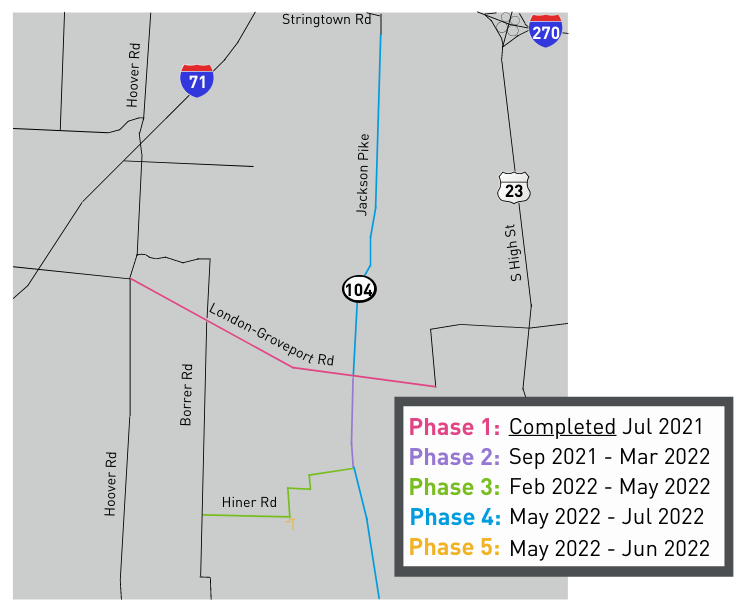

Project Map

FAQS

As part of our equipment upgrades, construction crews will be replacing existing poles and adding new electric lines as needed to improve system reliability and support economic growth in the area.

This work will help meet existing local electric needs and support future growth in your community by providing greater energy capacity and improved reliability.

We’re committed to keeping you informed throughout the duration of this project. We’ll work to notify you directly on what to expect if any of the planned work will impact you directly.

  • Phase 1 is scheduled to begin July 2021 and complete August 2021. Replace and install overhead lines and poles from the corner of Hoover Rd and London-Groveport Rd, continuing east along London-Groveport Rd to the corner beyond Jackson Pike.
  • Phase 2 is scheduled to begin July / August 2021 and complete late September 2021. Replace overhead lines and poles from the corner of London-Groveport Rd and Jackson Pike (S.R. 104), continuing south along Jackson Pike to the intersection with Hiner Rd.
  • Phase 3 is scheduled to begin August 2021 and complete November 2021. Replace overhead lines and poles along Hiner Rd from Strawser St to the intersection with Jackson Pike.
  • Phase 4 is scheduled to begin October 2021 and complete December 2021. Replace overhead lines and poles along Hiner Rd from Borrer Rd to Strawser St.
  • Phase 5 is scheduled to be completed in the fourth quarter of 2021. Install underground conduit and cable from Hiner Rd, continuing south along Strawser Rd within residential neighborhood.
  • Phase 6 is scheduled to be completed in the fourth quarter of 2021. Replace and install overhead lines and poles from the southwest corner of Stringtown Rd and Jackson Pike (S.R. 104), continuing south along Jackson Pike to the intersection with Durrett Rd.

We’ll notify you in advance with details of any work to be performed on your property. Please be sure we have the best phone number and email address to reach you at AEPOhio.com/Account.

You may experience a brief power outage when our crews install new electric equipment. These interruptions should not last more than two hours. We will notify you with details in advance of any scheduled outages. Please be sure we have your best contact information at AEPOhio.com/Account in case we need to get in touch.

Temporary lane closures along Jackson Pike and Hiner Road may be needed throughout the construction process. Additionally, areas along London-Groveport Road may require the road shoulder to be closed. We'll coordinate with local traffic control to minimize the impact to drivers while ensuring the safety of our crews and the community.
